Road Closure Request - Athgarvan Road, Newbridge

Hi,

There is currently a road closure on Athgarvan Road, Newbridge from entrance to Supervalu to Lidl entrance. This corresponds to Phases 1 & 2 of the notification on Irish Water website.


Permalink: https://waze.com/editor?env=row&lat=53.17515&lon=-6.79973&s=1178468351&zoom=9&segments=211890414,211890415

Reference: https://www.water.ie/projects-plans/newbridgewastewaterupgrad/

Thank you in advance,

Hey Shane, thanks for the very comprehensive post and sorry for only getting back to you now.

I closed the segments you linked for Phase 1 but I’m not sure how to proceed about scheduling the following phases. The article says Ph 1-6 will be 24/7 so shall we expire Ph1 at 23:59 and start Ph2 at 00:00? What do you think?


PL

Yes, I think it reads that Phase 1 should end on 17th at 23:59 and Phase 2 start on 17th at 00:00 as there will be overlap.

Realistically though, the dates are already looking indicative as they have closed off both Phase 1 and Phase 2 sections as of Thursday evening, 11th.

Sent from my ONEPLUS A5010 using Tapatalk

So for the time being I have Ph1 expiring on 17 Feb and Ph2 expiring on 25 Feb. I’ll hold off adding the subsequent closures in case the timeline becomes more fluid as they go. Keep us updated :slight_smile:

Will do. Thanks.

Sent from my ONEPLUS A5010 using Tapatalk

Edit: Double posted

@YanisKyr,

The next phase (3) is active now. Phase 1 has reopened so there is access to Cill Dara Industrial Estate from both ends.

Thanks,
Shane

Sent from my ONEPLUS A5010 using Tapatalk

Thanks for the heads-up Shane. So now I’m leaving Ph2 until 25 Feb 23:59, and adding Ph3 from now until 4 Mar 23:59.

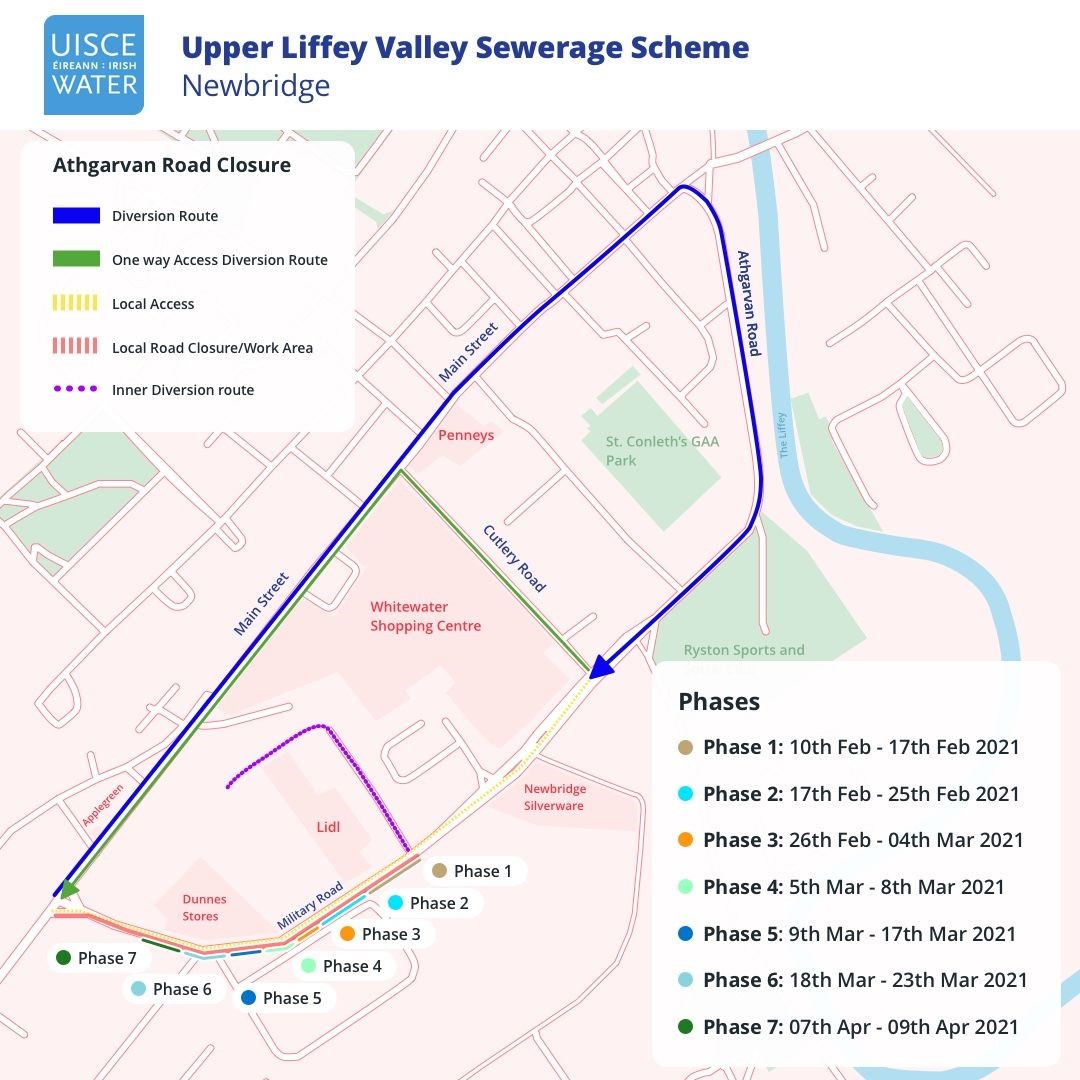

Would you mind running an eye over the screenshot below and check if I have the phases correctly marked? (4 and 5 are smaller sections but we will use one segment in the editor)

Ya that looks about right. Thanks.

Sent from my ONEPLUS A5010 using Tapatalk

Hi @YanisKyr,

Phase 4, 5 & 6 are now active. Phase 1-3 have been reopened.

Works appear to be running ahead of the schedule provided originally.

Thanks.

Good stuff, I’m re-opening Ph3 and closing Ph 4,5,6 until 23 Mar 23:59.

Hi @YanisKyr,

Closures under the above phases 1-7 have been completed.

The entrance to Cill Dara Industrial Estate is still closed (https://waze.com/editor?env=row&lat=53.17478&lon=-6.80112&s=1178468351&zoom=5&segments=211890499).

Phase 10 of the updated plan is now underway:
https://www.water.ie/projects-plans/newbridgewastewaterupgrad/

Thanks Shane. These drawings are pretty chaotic aren’t they…? Like a renaissance painting though, looking at it for a long time revealed the thin direction arrows in the most faint colours possible :mrgreen:

Could you please validate my interpretation (ignore the closures displayed in the screenshot)? Green arrows are the only allowed directions of travel at the junction of R445 Moorefield Rd and Athgarvan Rd. West entrance to the Industrial Estate is closed. And these are valid from now until 26 Mar and 7-12 Apr?

Hi YanisKyr,

Yes that looks correct. They seem to have been running ahead of time up to now but I guess we can only work with the advertised dates.

Agree the drawings are difficult to read for the public. Guess somebody was lazy and just took the detailed site works drawings used for getting the road closures.

Thanks,
Shane

I was able to put these through except disabling the right turn from Athgarvan Rd to R445. This will have to wait until the next tile update which will hopefully be tomorrow. As soon as the new tiles go live, the turn will be restricted.

I’ve got a reminder to revisit and replace the disabled turn with a proper real-time closure.

Current closures are in place until 23:59 on 12 Apr by the way. Any news from the ground? :ugeek:

Hi Yanis,

Sorry hadn’t been there recently to check.

Works have now moved on as noted in this map issue:
https://www.waze.com/editor/?zoom=5&lat=53.174608&lon=-6.803355&mapUpdateRequest=1581190

The current update on the Irish Water website https://www.water.ie/projects-plans/newbridgewastewaterupgrad/ has the current work sequence but no dates:

Hi Shane, not sure if you submitted a new UR about these ongoing works, but I’m uncertain which Phase is closed at the moment. In any case, any local knowledge you can share?
