A couple of weeks ago, we had a major batch of these closure MPs appear. I did practically nothing else last week and have probably dealt with about 700 closure MPs over the last 2 weeks. So I’ll share a few thoughts from my experience.
Small closures in long segments. Often these closures are at bridges/underpasses. As said above, if the closure isn’t for a few days, you have a chance to split the segment and set the correct elevations. Whilst you’re at it, I would advise doing the same for any other bridges you see nearby. Rail bridges, in particular, often have maintenance work or scheduled inspections. If you split them now, it will be much easier next time there’s a closure. Plus, it drives me crazy when I see a 1 mile segment at elevation -1 because 30 yards of it goes under a dual carriageway! :twisted:
If a closure in a long segment isn’t at a bridge, it may not be worth splitting it. Another editor may come along later and remove the split anyway. Most of these tend to be in rural areas anyway. Consider who you’re implementing a closure for: is it a very small number of local visitors, or for people who would otherwise be routing through here on the way elsewhere? If there are few destinations on the long segment, perhaps you can just close the whole thing?
Roadworks.org is Elgin: every closure MP will have details from roadworks.org. But to find them, you may need to select a few extra things from their layers menu:
- Live Incidents: Road closures
- Road closures & diversions: Road closure, Diversion route (helps you visualise what’s going on), Bridge closure
- Traffic restrictions: Road closure crossing
- Public events: All of them. Many of these closure MPs are for special events
Don’t forget to view roadworks for, at least, the next 2 weeks. It defaults to “today” and keeps changing back to that! Often, the detail popups for the icons will have links to useful documents like Traffic Restriction Orders. Sometimes the closure icon won’t have details, but there will be an associated roadworks icon that does.
Cul-de-sacs. I need to slightly disagree with Tim. :shock: You don’t necessarily have to add these closures - their effect on Waze routing is truly minimal. But I wouldn’t mark them as irrelevant - if they are correct, why effectively “mark down” the data supplier?
Hertfordshire CC have a really bad habit. They publish a load of closures along the lines of “Closed for 2 days within this 20 day period from micro-surfacing”. What can you do? Mark them as irrelevant and move on.
Duplicate MPs. Some of the big batch of closures were duplicated. Whether that will be an ongoing thing I don’t know, but keep an eye out for second closure MPs directly under the first one.

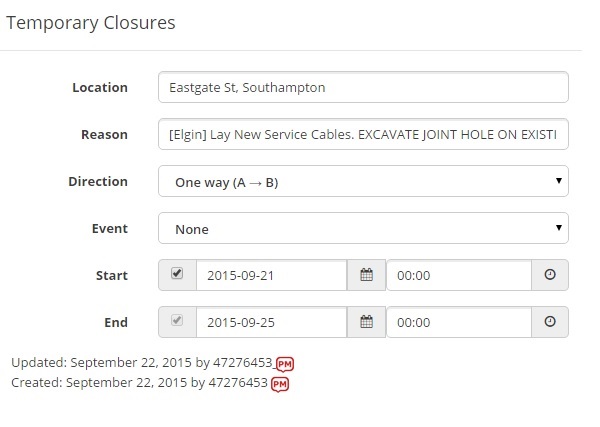

Times The MPs almost all state a time of 00:00 to 23:59. I’m sure that’s because the closure times are not included as an available part of the structured data. Even if roadworks.org has the times, they are often in the text description. Generally speaking, I start closures at 6am (assuming they may close the road an hour or two before starting work) and end closures at 8pm (allowing time for finishing a bit late). If a closure is Monday to Monday, I sometimes assume that, because it apparently includes weekend working, the closure is aimed to finish in time for Monday morning traffic - particularly if it’s a major road. In those cases, I set an end time of 6am Monday. These are all guesses - feel free to make your own.
